• Tidak ada hasil yang ditemukan

BAB IV PEMBAHASAN. Tabel 4.1 Actual Cost Minggu 1 s/d 20

N/A
N/A
Protected

Academic year: 2021

Membagikan "BAB IV PEMBAHASAN. Tabel 4.1 Actual Cost Minggu 1 s/d 20"

Copied!
28
0
0

Teks penuh

(1)

BAB IV PEMBAHASAN

4.1 DATA

Data proyek pembangunan gedung Telkomsel Telecommunication Center Manado II pada minggu ke-20 (dua puluh) adalah sebagai berikut :

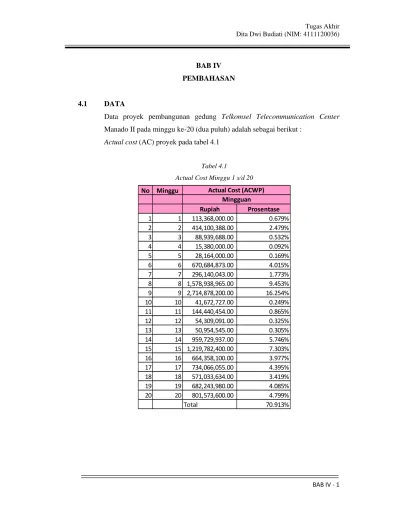

Actual cost (AC) proyek pada tabel 4.1

Tabel 4.1

Actual Cost Minggu 1 s/d 20

No Minggu Rupiah Prosentase 1 1      113,368,000.00 0.679% 2 2      414,100,388.00 2.479% 3 3        88,939,688.00 0.532% 4 4        15,380,000.00 0.092% 5 5        28,164,000.00 0.169% 6 6      670,684,873.00 4.015% 7 7      296,140,043.00 1.773% 8 8 1,578,938,965.00  9.453% 9 9 2,714,878,200.00  16.254% 10 10        41,672,727.00 0.249% 11 11      144,440,454.00 0.865% 12 12        54,309,091.00 0.325% 13 13        50,954,545.00 0.305% 14 14      959,729,937.00 5.746% 15 15 1,219,782,400.00  7.303% 16 16      664,358,100.00 3.977% 17 17      734,066,055.00 4.395% 18 18      571,033,634.00 3.419% 19 19      682,243,980.00 4.085% 20 20      801,573,600.00 4.799% Total 70.913% Mingguan Actual Cost (ACWP)

(2)

Tabel 4.2

Hasil Perbandingan BCWS vs. ACWP (Biaya rencana vs. aktual)

No Minggu

Mingguan Kumulatif Mingguan Kumulatif Mingguan Kumulatif Biaya/minggu faktor/isu yang terjadi

1 1 0,234% 0,234% 0,679% 0,679% ‐0,444% ‐0,444% (‐) 2 2 0,246% 0,480% 2,479% 3,158% ‐2,233% ‐2,678% (‐) 3 3 0,321% 0,802% 0,532% 3,690% ‐0,211% ‐2,889% (‐) 4 4 0,646% 1,448% 0,092% 3,782% 0,554% ‐2,334% (+) 5 5 0,941% 2,389% 0,169% 3,951% 0,772% ‐1,563% (+) 6 6 1,158% 3,547% 4,015% 7,966% ‐2,857% ‐4,420% (‐) 7 7 1,190% 4,737% 1,773% 9,739% ‐0,583% ‐5,002% (‐) 8 8 1,518% 6,255% 9,453% 19,192% ‐7,935% ‐12,937% (‐) 9 9 1,799% 8,054% 16,254% 35,446% ‐14,454% ‐27,391% (‐) 10 10 1,756% 9,810% 0,249% 35,695% 1,506% ‐25,885% (+) 11 11 1,904% 11,714% 0,865% 36,560% 1,039% ‐24,846% (+) 12 12 1,914% 13,628% 0,325% 36,885% 1,589% ‐23,258% (+) 13 13 2,035% 15,662% 0,305% 37,190% 1,730% ‐21,528% (+) 14 14 1,505% 17,167% 5,746% 42,936% ‐4,241% ‐25,769% (‐) 15 15 1,464% 18,631% 7,303% 50,239% ‐5,839% ‐31,608% (‐) 16 16 1,456% 20,086% 3,977% 54,216% ‐2,522% ‐34,130% (‐) 17 17 1,384% 21,470% 4,395% 58,611% ‐3,011% ‐37,141% (‐) 18 18 1,974% 23,444% 3,419% 62,030% ‐1,444% ‐38,585% (‐) 19 19 1,457% 24,901% 4,085% 66,114% ‐2,628% ‐41,213% (‐) 20 20 1,686% 26,588% 4,799% 70,913% ‐3,112% ‐44,326% (‐) Biaya aktual lebih besar daripada  rencana, karena material arsitektur  dan M/E dengan spesifikasi  khusus/impor harus dipesan jauh  sebelum terpasang, begitu pula  dengan pembayarannya di awal,  pengiriman material dalam jumlah  banyak. Biaya aktual kurang dari rencana,  pembayaran untuk order material  tidak terlalu banyak pada minggu ini. Biaya aktual jauh lebih besar daripada  rencana, dikarenakan sudah mulai  banyak pekerjaan di lapangan,  penambahan jumlah tenaga kerja,  pengiriman material dalam jumlah  banyak serta pelunasan material.  Pada minggu ke‐20, order material  sudah mencapai hampir 90% dari  total keseluruhan material yang di list  untuk proyek, namun belum termasuk  jika terjadi change order atau defect. ACWP Biaya aktual lebih besar daripada  rencana, karena pengeluaran  (cashflow) untuk order material  belum direncanakan dengan baik. Biaya aktual kurang dari rencana,  pembayaran untuk order material  tidak terlalu banyak pada minggu ini. BCWS Deviasi Biaya Keterangan

(3)

Tabel 4.3

Hasil Perbandingan BCWS vs. BCWP (Progress rencana vs. aktual)

No Minggu

Mingguan Kumulatif Mingguan Kumulatif Mingguan Kumulatif Progress/minggu faktor/isu yang terjadi

1 1 0,234% 0,234% 0,287% 0,287% 0,053% 0,053% (+) positif : perijinan IMB telah keluar  lebih cepat dari rencana, negatif : ijin  masuk proyek sementara hanya untuk  mengukuran, belum diperbolehkan  adanya pekerjaan fisik. 2 2 0,246% 0,480% 0,359% 0,647% 0,113% 0,166% (+) positif : telah dilakukan pengukuran  lahan, negatif : belum mendapat ijin  masuk lokasi proyek untuk  melaksanakan pekerjaan fisik, tim di  lapangan belum lengkap. 3 3 0,321% 0,802% 0,270% 0,916% ‐0,052% 0,115% (‐) positif : pembersihan lokasi & direksi  keet on going, negatif : pembersihan  lokasi & pembongkaran bangunan  eksisting berjalan lambat, curah  hujan. 4 4 0,646% 1,448% 0,748% 1,664% 0,101% 0,216% (+) positif : penyediaan air bersih untuk  proyek, negatif : alat bored pile belum  tiba di lokasi, curah hujan, change  order rencana rumah genset beserta  gensetnya. 5 5 0,941% 2,389% 1,053% 2,717% 0,113% 0,329% (+) positif : pembongkaran bangunan  eksisting selesai, pemasangan  bowplank, fabrikasi besi beton on  going, negatif : alat bored pile belum  tiba di lokasi, curah hujan, change  order belum fixed. 6 6 1,158% 3,547% 0,481% 3,198% ‐0,677% ‐0,349% (‐) positif : fabrikasi besi beton on going,  alat bored pile sudah bekerja, negatif :  kepengurusan asuransi terlambat,  curah hujan 7 7 1,190% 4,737% 1,310% 4,508% 0,120% ‐0,229% (+) positif : pek.struktur sudah mulai  berjalan, negatif : curah hujan,  beberapa kali listrik kerja (PLN) mati,  pek. Struktur terlambat 8 8 1,518% 6,255% 1,006% 5,514% ‐0,512% ‐0,741% (‐) positif : pek. Struktur on going, negatif  : curah hujan 9 9 1,799% 8,054% 1,307% 6,821% ‐0,492% ‐1,233% (‐) positif : pek. Pondasi bored pile  selesai, negatif : menunggu hasil PDA  tes untuk melaksanakan pek. Struktur  selanjutnya, curah hujan 10 10 1,756% 9,810% 1,513% 8,334% ‐0,243% ‐1,476% (‐) positif : pek. Struktur on going, negatif  : curah hujan, pek. Struktur terlambat Progress Keterangan BCWS BCWP Deviasi

(4)

Hasil Perbandingan BCWS vs. BCWP (lanjutan)

No Minggu

Mingguan Kumulatif Mingguan Kumulatif Mingguan Kumulatif Progress/minggu faktor/isu yang terjadi

11 11 1,904% 11,714% 2,713% 11,046% 0,809% ‐0,667% (+) positif : pek. Struktur on going, negatif  : curah hujan 12 12 1,914% 13,628% 1,205% 12,251% ‐0,709% ‐1,376% (‐) positif : pek. Struktur on going, negatif  : curah hujan, kelangkaan beton  readymix 13 13 2,035% 15,662% 0,891% 13,142% ‐1,143% ‐2,520% (‐) positif : pek. Struktur on going, negatif  : curah hujan, kelangkaan beton  readymix, ijin relokasi M/E bangunan  eksisting belum keluar, proses ijin  warga (IW) tower belum selesai. 14 14 1,505% 17,167% 0,715% 13,858% ‐0,789% ‐3,309% (‐) positif : pek. Struktur on going, negatif  : curah hujan, ijin relokasi M/E  bangunan eksisting belum keluar. 15 15 1,464% 18,631% 1,510% 15,367% 0,046% ‐3,263% (+) positif : pek. Struktur on going, negatif  : curah hujan, ijin relokasi M/E  bangunan eksisting belum keluar,  keterlambatan material, kekurangan  tenaga kerja. 16 16 1,456% 20,086% 1,458% 16,825% 0,002% ‐3,262% (+) positif : pek. Struktur on going, negatif  : curah hujan, ijin relokasi M/E  bangunan eksisting belum keluar,  keterlambatan material, kekurangan  tenaga kerja. 17 17 1,384% 21,470% 1,312% 18,137% ‐0,072% ‐3,333% (‐) positif : pek. Struktur, arsitek, M/E on  going, negatif : keterlambatan  material. 18 18 1,974% 23,444% 1,462% 19,599% ‐0,512% ‐3,845% (‐) positif : pek. Struktur, arsitek, M/E on  going, perijinan PLN, PDAM, Situ &  reklame, depnaker, telkom/telpon on  going, negatif : kekurangan tenaga  kerja. 19 19 1,457% 24,901% 1,493% 21,092% 0,036% ‐3,809% (+) positif : pek. Struktur, arsitek, M/E on  going, perijinan PLN, PDAM, Situ &  reklame, depnaker, telkom/telpon on  going, negatif : kekurangan tenaga  kerja. 20 20 1,686% 26,588% 1,414% 22,506% ‐0,273% ‐4,082% (‐) positif : pek. Struktur, arsitek, M/E on  going, negatif : keterlambatan  material (dari vendor), kekurangan  tenaga kerja. Progress Keterangan BCWS BCWP Deviasi

(5)

Tabel 4.4

Hasil Perbandingan BCWP vs. ACWP (Nilai fisik proyek vs. biaya aktual)

No Minggu

Mingguan Kumulatif Mingguan Kumulatif Mingguan Kumulatif Biaya Faktor

1 1 0,287% 0,287% 0,679% 0,679% ‐0,391% ‐0,391% ‐ Biaya aktual proyek pada minggu ini  melebihi nilai fisiknya sebesar 0.391%  dikarenakan terhambatnya proses ijin  masuk ke lokasi 2 2 0,359% 0,647% 2,479% 3,158% ‐2,120% ‐2,511% ‐ Biaya aktual proyek pada minggu ini  melebihi nilai fisiknya sebesar 2.120%  dikarenakan terhambatnya proses ijin  masuk ke lokasi 3 3 0,270% 0,916% 0,532% 3,690% ‐0,263% ‐2,774% ‐ Biaya aktual proyek pada minggu ini  melebihi nilai fisiknya sebesar 0.263%  dikarenakan minggu ini direncanakan  sudah ada pekerjaan struktur, namun  baru mendapat ijin masuk lokasi &  baru bisa melakukan pek.persiapan 4 4 0,748% 1,664% 0,092% 3,782% 0,656% ‐2,119% + Nilai fisik proyek pada minggu ini  melebihi biaya aktualnya sebesar  0.656% dikarenakan pada minggu ini  biaya yang dikeluarkan proyek relatif  kecil yaitu 0.092% 5 5 1,053% 2,717% 0,169% 3,951% 0,885% ‐1,234% + Nilai fisik proyek pada minggu ini  melebihi biaya aktualnya sebesar  0.885% dikarenakan pada minggu ini  biaya yang dikeluarkan proyek relatif  kecil yaitu 0.169% 6 6 0,481% 3,198% 4,015% 7,966% ‐3,534% ‐4,768% ‐ Biaya aktual proyek pada minggu ini  melebihi nilai fisiknya sebesar 3.534%  dikarenakan pada minggu ini proyek  melakukan pembayaran material  cukup besar yaitu 4.015% 7 7 1,310% 4,508% 1,773% 9,739% ‐0,463% ‐5,231% ‐ Biaya aktual proyek pada minggu ini  melebihi nilai fisiknya sebesar 0.463% 8 8 1,006% 5,514% 9,453% 19,192% ‐8,447% ‐13,678% ‐ Biaya aktual proyek pada minggu ini  melebihi nilai fisiknya sebesar 8.447%  dikarenakan pada minggu ini proyek  melakukan pembayaran material  cukup besar yaitu 9.453% 9 9 1,307% 6,821% 16,254% 35,446% ‐14,947% ‐28,625% ‐ Biaya aktual proyek pada minggu ini  melebihi nilai fisiknya sebesar  14.947% dikarenakan pada minggu ini  proyek melakukan pembayaran  material cukup besar yaitu 16.254% 10 10 1,513% 8,334% 0,249% 35,695% 1,263% ‐27,361% + Nilai fisik proyek pada minggu ini  melebihi biaya aktualnya sebesar  1.263% dikarenakan pada minggu ini  biaya yang dikeluarkan proyek relatif  kecil yaitu 0.249% Biaya Keterangan BCWP ACWP Deviasi

(6)

Hasil Perbandingan BCWP vs. ACWP (lanjutan)

No Minggu

Mingguan Kumulatif Mingguan Kumulatif Mingguan Kumulatif Biaya Faktor

11 11 2,713% 11,046% 0,865% 36,560% 1,848% ‐25,514% + Nilai fisik proyek pada minggu ini  melebihi biaya aktualnya sebesar  1.848% dikarenakan pada minggu ini  biaya yang dikeluarkan proyek relatif  kecil yaitu 0.865% 12 12 1,205% 12,251% 0,325% 36,885% 0,879% ‐24,634% + Nilai fisik proyek pada minggu ini  melebihi biaya aktualnya sebesar  0.879% dikarenakan pada minggu ini  biaya yang dikeluarkan proyek relatif  kecil yaitu 0.325% 13 13 0,891% 13,142% 0,305% 37,190% 0,586% ‐24,048% + Nilai fisik proyek pada minggu ini  melebihi biaya aktualnya sebesar  0.586% dikarenakan pada minggu ini  biaya yang dikeluarkan proyek relatif  kecil yaitu 0.305% 14 14 0,715% 13,858% 5,746% 42,936% ‐5,030% ‐29,079% ‐ Biaya aktual proyek pada minggu ini  melebihi nilai fisiknya sebesar 5.030%  dikarenakan pada minggu ini proyek  melakukan pembayaran material  cukup besar yaitu 5.746% sementara  nilai fisik terhambat oleh  keterlambatan delivery material bata  ringan 15 15 1,510% 15,367% 7,303% 50,239% ‐5,793% ‐34,872% ‐ Biaya aktual proyek pada minggu ini  melebihi nilai fisiknya sebesar 5.793%  dikarenakan pada minggu ini proyek  melakukan pembayaran material  cukup besar yaitu 7.303% 16 16 1,458% 16,825% 3,977% 54,216% ‐2,520% ‐37,391% ‐ 17 17 1,312% 18,137% 4,395% 58,611% ‐3,083% ‐40,474% ‐ 18 18 1,462% 19,599% 3,419% 62,030% ‐1,957% ‐42,431% ‐ 19 19 1,493% 21,092% 4,085% 66,114% ‐2,591% ‐45,022% ‐ 20 20 1,414% 22,506% 4,799% 70,913% ‐3,385% ‐48,407% ‐ Biaya Keterangan BCWP ACWP Deviasi Biaya aktual proyek pada minggu 16  s/d 20 melebihi nilai fisiknya   dikarenakan pada minggu‐minggu  tersebut proyek melakukan  pembayaran cukup besar untuk  material M/E sedangkan pek.  arsitektur blm selesai, sementara  banyak pek. M/E baru bisa  dilaksanakan setelah pek. arsitektur  hampir selesai mengingat gedung  yang akan dibangun memiliki nilai  M/E lebih dari 50% dari total  keseluruhan nilai kontrak

(7)

Tabel 4.5

Perbandingan Plan Value, Earned Value dan Actual Cost

No Minggu 1 1 0.234% 0.234% 0.287% 0.287% 0.679% 0.679% 2 2 0.246% 0.480% 0.359% 0.647% 2.479% 3.158% 3 3 0.321% 0.802% 0.270% 0.916% 0.532% 3.690% 4 4 0.646% 1.448% 0.748% 1.664% 0.092% 3.782% 5 5 0.941% 2.389% 1.053% 2.717% 0.169% 3.951% 6 6 1.158% 3.547% 0.481% 3.198% 4.015% 7.966% 7 7 1.190% 4.737% 1.310% 4.508% 1.773% 9.739% 8 8 1.518% 6.255% 1.006% 5.514% 9.453% 19.192% 9 9 1.799% 8.054% 1.307% 6.821% 16.254% 35.446% 10 10 1.756% 9.810% 1.513% 8.334% 0.249% 35.695% 11 11 1.904% 11.714% 2.713% 11.046% 0.865% 36.560% 12 12 1.914% 13.628% 1.205% 12.251% 0.325% 36.885% 13 13 2.035% 15.662% 0.891% 13.142% 0.305% 37.190% 14 14 1.505% 17.167% 0.715% 13.858% 5.746% 42.936% 15 15 1.464% 18.631% 1.510% 15.367% 7.303% 50.239% 16 16 1.456% 20.086% 1.458% 16.825% 3.977% 54.216% 17 17 1.384% 21.470% 1.312% 18.137% 4.395% 58.611% 18 18 1.974% 23.444% 1.462% 19.599% 3.419% 62.030% 19 19 1.457% 24.901% 1.493% 21.092% 4.085% 66.114% 20 20 1.686% 26.588% 1.414% 22.506% 4.799% 70.913% Biaya BCWS (PV) BCWP (EV) ACWP (AC)

Dalam perencanaan, total biaya yang dikeluarkan / planned value (PV) minggu ke-20 adalah Rp 4.440.974.821,96 atau 26,588%. Nilai hasil yang dicapai / earned value (EV) minggu ke-20 adalah Rp 3.759.220.995,14 atau 22,506%. Sedangkan anggaran proyek keseluruhan adalah Rp 16.703.182.634,22 atau

100%.

Pekerjaan telah berlangsung 20 minggu (140 hari), dengan total keseluruhan waktu pelaksanaan 240 hari, sehingga tersisa waktu pelaksanaan adalah 100 hari.

(8)

4.2 ANALISIS

4.2.1 Varians Biaya dan Jadual Terpadu

Varians Biaya/Cost Varians (CV) dan Varian Jadwal/Schedule Varians (SV) diformulasikan sebagai berikut:

Varian Biaya (CV) = EV – AC Varian Jadwal (SV) = EV – PV

Tabel 4.6

Hasil Varian Biaya dan Varian Jadwal /Minggu

No Minggu Keterangan (1) (2) (3) (4) (5) 1 1 0.234% 0.287% 0.679% ‐0.391% ‐ 0.053% + Pekerjaan selesai lebih cepat  dari jadwal, menelan biaya di  atas anggaran 2 2 0.246% 0.359% 2.479% ‐2.120% ‐ 0.113% + Pekerjaan selesai lebih cepat  dari jadwal, menelan biaya di  atas anggaran 3 3 0.321% 0.270% 0.532% ‐0.263% ‐ ‐0.052% ‐ Pekerjaan selesai terlambat,  menelan biaya di atas  anggaran 4 4 0.646% 0.748% 0.092% 0.656% + 0.101% + Pekerjaan selesai lebih cepat  dari jadwal, menelan biaya  sesuai anggaran 5 5 0.941% 1.053% 0.169% 0.885% + 0.113% + Pekerjaan selesai lebih cepat  dari jadwal, menelan biaya  sesuai anggaran 6 6 1.158% 0.481% 4.015% ‐3.534% ‐ ‐0.677% ‐ Pekerjaan selesai terlambat,  menelan biaya di atas  anggaran 7 7 1.190% 1.310% 1.773% ‐0.463% ‐ 0.120% + Pekerjaan selesai lebih cepat  dari jadwal, menelan biaya di  atas anggaran 8 8 1.518% 1.006% 9.453% ‐8.447% ‐ ‐0.512% ‐ Pekerjaan selesai terlambat,  menelan biaya di atas  anggaran 9 9 1.799% 1.307% 16.254% ‐14.947% ‐ ‐0.492% ‐ Pekerjaan selesai terlambat,  menelan biaya di atas  anggaran 10 10 1.756% 1.513% 0.249% 1.263% + ‐0.243% ‐ Pekerjaan selesai terlambat,  menelan biaya sesuai  anggaran = EV‐AC = (4)‐(5) Varian Jadwal (SV) = EV‐PV = (4)‐(3) Biaya BCWS (PV) BCWP (EV) ACWP (AC) Varians Biaya dan Jadual Terpadu Varian Biaya (CV)

(9)

Hasil Varian Biaya dan Varian Jadwal /Minggu (lanjutan) No Minggu Keterangan (1) (2) (3) (4) (5) 11 11 1.904% 2.713% 0.865% 1.848% + 0.809% + Pekerjaan selesai lebih cepat  dari jadwal, menelan biaya  sesuai anggaran 12 12 1.914% 1.205% 0.325% 0.879% + ‐0.709% ‐ Pekerjaan selesai terlambat,  menelan biaya sesuai  anggaran 13 13 2.035% 0.891% 0.305% 0.586% + ‐1.143% ‐ Pekerjaan selesai terlambat,  menelan biaya sesuai  anggaran 14 14 1.505% 0.715% 5.746% ‐5.030% ‐ ‐0.789% ‐ Pekerjaan selesai terlambat,  menelan biaya di atas  anggaran 15 15 1.464% 1.510% 7.303% ‐5.793% ‐ 0.046% + Pekerjaan selesai lebih cepat  dari jadwal, menelan biaya di  atas anggaran 16 16 1.456% 1.458% 3.977% ‐2.520% ‐ 0.002% + Pekerjaan selesai lebih cepat  dari jadwal, menelan biaya di  atas anggaran 17 17 1.384% 1.312% 4.395% ‐3.083% ‐ ‐0.072% ‐ Pekerjaan selesai terlambat,  menelan biaya di atas  anggaran 18 18 1.974% 1.462% 3.419% ‐1.957% ‐ ‐0.512% ‐ Pekerjaan selesai terlambat,  menelan biaya di atas  anggaran 19 19 1.457% 1.493% 4.085% ‐2.591% ‐ 0.036% + Pekerjaan selesai lebih cepat  dari jadwal, menelan biaya di  atas anggaran 20 20 1.686% 1.414% 4.799% ‐3.385% ‐ ‐0.273% ‐ Pekerjaan selesai terlambat,  menelan biaya di atas  anggaran ‐48.407% ‐ ‐4.082% ‐ Pekerjaan selesai terlambat,  menelan biaya di atas  anggaran = EV‐AC = (4)‐(5) Varian Jadwal (SV) = EV‐PV = (4)‐(3) Biaya BCWS (PV) BCWP (EV) ACWP (AC) Varians Biaya dan Jadual Terpadu Varian Biaya (CV) Kumulatif   (Analisis varian terpadu, Imam Soeharto, 1997)

(10)

4.2.2 Indeks Produktivitas dan Kinerja

Indeks kinerja ini terdiri dari Indeks Kinerja Biaya (Cost Performance Index = CPI) dan Indeks Kinerja Jadual (Schedule Performance Index = SPI) Adapun rumusan Indeks kinerja ini adalah :

Indeks Kinerja Biaya (CPI) = EV/AC Indeks Kinerja Jadwal (SPI) = EV/ PV

Tabel 4.7

Hasil Indeks Kinerja Biaya dan Indeks Kinerja Jadwal /Minggu

No Minggu Keterangan (1) (2) (3) (4) (5) 1 1 0.234% 0.287% 0.679% 0.423 < 1 1.226 > 1 Produktivitas tenaga kerja &  alat cukup baik, cashflow  kurang stabil 2 2 0.246% 0.359% 2.479% 0.145 < 1 1.462 > 1 Produktivitas tenaga kerja &  alat cukup baik, cashflow  kurang stabil 3 3 0.321% 0.270% 0.532% 0.506 < 1 0.839 < 1 Produktivitas tenaga kerja &  alat kurang baik, cashflow  kurang stabil 4 4 0.646% 0.748% 0.092% 8.119 > 1 1.156 > 1 Produktivitas tenaga kerja &  alat cukup baik, cashflow  cukup stabil 5 5 0.941% 1.053% 0.169% 6.247 > 1 1.120 > 1 Produktivitas tenaga kerja &  alat cukup baik, cashflow  cukup stabil 6 6 1.158% 0.481% 4.015% 0.120 < 1 0.415 < 1 Produktivitas tenaga kerja &  alat kurang baik, cashflow  kurang stabil 7 7 1.190% 1.310% 1.773% 0.739 < 1 1.100 > 1 Produktivitas tenaga kerja &  alat cukup baik, cashflow  kurang stabil 8 8 1.518% 1.006% 9.453% 0.106 < 1 0.663 < 1 Produktivitas tenaga kerja &  alat kurang baik, cashflow  kurang stabil 9 9 1.799% 1.307% 16.254% 0.080 < 1 0.726 < 1 Produktivitas tenaga kerja &  alat kurang baik, cashflow  kurang stabil 10 10 1.756% 1.513% 0.249% 6.063 > 1 0.862 < 1 Produktivitas tenaga kerja &  alat kurang baik, cashflow  cukup stabil CPI = EV/AC = (4)/(5) SPI = EV/PV = (4)/(3) Biaya Indeks Produktivitas dan Kinerja BCWS (PV) BCWP (EV) ACWP (AC)

(11)

Hasil Indeks Kinerja Biaya dan Indeks Kinerja Jadwal /Minggu (lanjutan) No Minggu Keterangan (1) (2) (3) (4) (5) 11 11 1.904% 2.713% 0.865% 3.137 > 1 1.425 > 1 Produktivitas tenaga kerja &  alat cukup baik, cashflow  cukup stabil 12 12 1.914% 1.205% 0.325% 3.705 > 1 0.629 < 1 Produktivitas tenaga kerja &  alat kurang baik, cashflow  cukup stabil 13 13 2.035% 0.891% 0.305% 2.921 > 1 0.438 < 1 Produktivitas tenaga kerja &  alat kurang baik, cashflow  cukup stabil 14 14 1.505% 0.715% 5.746% 0.124 < 1 0.475 < 1 Produktivitas tenaga kerja &  alat kurang baik, cashflow  kurang stabil 15 15 1.464% 1.510% 7.303% 0.207 < 1 1.031 > 1 Produktivitas tenaga kerja &  alat cukup baik, cashflow  kurang stabil 16 16 1.456% 1.458% 3.977% 0.366 < 1 1.001 > 1 Produktivitas tenaga kerja &  alat cukup baik, cashflow  kurang stabil 17 17 1.384% 1.312% 4.395% 0.299 < 1 0.948 < 1 Produktivitas tenaga kerja &  alat kurang baik, cashflow  kurang stabil 18 18 1.974% 1.462% 3.419% 0.428 < 1 0.741 < 1 Produktivitas tenaga kerja &  alat kurang baik, cashflow  kurang stabil 19 19 1.457% 1.493% 4.085% 0.366 < 1 1.025 > 1 Produktivitas tenaga kerja &  alat cukup baik, cashflow  kurang stabil 20 20 1.686% 1.414% 4.799% 0.295 < 1 0.838 < 1 Produktivitas tenaga kerja &  alat kurang baik, cashflow  kurang stabil CPI = EV/AC = (4)/(5) SPI = EV/PV = (4)/(3) Biaya Indeks Produktivitas dan Kinerja BCWS (PV) BCWP (EV) ACWP (AC)

(12)

4.2.3 Proyeksi Pengeluaran Biaya dan Jangka Waktu Penyelesaian Proyek

Membuat prakiraan biaya atau jadual penyelesaian proyek berdasarkan atas indikator yang diperoleh saat pelaporan, akan memberikan petunjuk besarnya biaya pada akhir proyek (estimasi at completion = EAC) dan prakiraan waktu peneyelesaian proyek (estimate all schedule = EAS)

ETC = (BAC – BCWP) / CPI = (BAC – EV) / CPI

EAC = ACWP – ETC

Sedangkan prakiraan waktu penyelesaian seluruh pekerjaan: ETS = (Sisa waktu ) / SPI

= 100 hari SPI

EAS = Keseluruhan waktu yang tersedia + ETS = 240 hari + ETS

Dimana:

BAC (Budget At Completion) = Anggaran Proyek Keseluruhan. SPI (Schedule Performance Index) = Indek Kinerja Jadwal.

CPI (Cost Performance Index) = Indek Kinerja Biaya

ETC (Estimate Temporary Cost) = Prakiraan Biaya untuk Pekerjaan Tersisa.

EAC (Estimate All Cost) = PrakiraanTotal Biaya Proyek. ETS (Estimate Temporary Schedule) = Prakiraan Waktu Untuk

Pekerjaan Tersisa.

(13)

No M in gg u BA C BC W S  (P V) BC W P  (E V) AC W P  (A C) CP I SP I ET C EA C ETS EA S =  EV /A C =  EV /P V =( BA C‐ EV )/ CP I =A C‐ ET C =  si sa  w ak tu /S PI =tota l wa kt u+ ET S (1 ) (2 ) (3 ) (4 ) (5 ) (6 ) (7 )=  (5 )/ (6 ) (8 )=  (5 )/ (4 ) (9 )= ((3 )‐ (5 ))/ (7 ) (1 0)= (6 )‐ (9 ) 1 1 10 0% 0. 234 % 0. 28 7% 0. 679% 0. 42 3 1. 22 6 235 .5 05% ‐2 34. 826 % 82 322 2 2 10 0% 0. 480 % 0. 64 7% 3. 158% 0. 20 5 1. 34 6 485 .2 39% ‐4 82. 081 % 74 314 3 3 10 0% 0. 802 % 0. 91 6% 3. 690% 0. 24 8 1. 14 3 399 .1 08% ‐3 95. 418 % 87 327 4 4 10 0% 1. 448 % 1. 66 4% 3. 782% 0. 44 0 1. 14 9 223 .5 60% ‐2 19. 778 % 87 327 5 5 10 0% 2. 389 % 2. 71 7% 3. 951% 0. 68 8 1. 13 8 141 .4 63% ‐1 37. 512 % 88 328 6 6 10 0% 3. 547 % 3. 19 8% 7. 966% 0. 40 1 0. 90 2 241 .1 31% ‐2 33. 165 % 11 1 351 7 7 10 0% 4. 737 % 4. 50 8% 9. 739% 0. 46 3 0. 95 2 206 .3 07% ‐1 96. 567 % 10 5 345 8 8 10 0% 6. 255 % 5. 51 4% 19. 192% 0. 28 7 0. 88 2 328 .8 53% ‐3 09. 660 % 11 3 353 9 9 10 0% 8. 054 % 6. 82 1% 35. 446% 0. 19 2 0. 84 7 484 .2 01% ‐4 48. 756 % 11 8 358 10 10 10 0% 9. 810 % 8. 33 4% 35. 695% 0. 23 3 0. 85 0 392 .6 19% ‐3 56. 924 % 11 8 358 11 11 10 0% 11. 714 % 11. 04 6% 36 .560% 0. 30 2 0. 94 3 294 .4 06% ‐2 57. 846 % 10 6 346 12 12 10 0% 13. 628 % 12. 25 1% 36 .885% 0. 33 2 0. 89 9 264 .1 91% ‐2 27. 306 % 11 1 351 13 13 10 0% 15. 662 % 13. 14 2% 37 .190% 0. 35 3 0. 83 9 245 .7 92% ‐2 08. 602 % 11 9 359 14 14 10 0% 17. 167 % 13. 85 8% 42 .936% 0. 32 3 0. 80 7 266 .9 02% ‐2 23. 966 % 12 4 364 15 15 10 0% 18. 631 % 15. 36 7% 50 .239% 0. 30 6 0. 82 5 276 .6 84% ‐2 26. 445 % 12 1 361 16 16 10 0% 20. 086 % 16. 82 5% 54 .216% 0. 31 0 0. 83 8 268 .0 24% ‐2 13. 808 % 11 9 359 17 17 10 0% 21. 470 % 18. 13 7% 58 .611% 0. 30 9 0. 84 5 264 .5 48% ‐2 05. 937 % 11 8 358 18 18 10 0% 23. 444 % 19. 59 9% 62 .030% 0. 31 6 0. 83 6 254 .4 66% ‐1 92. 436 % 12 0 360 19 19 10 0% 24. 901 % 21. 09 2% 66 .114% 0. 31 9 0. 84 7 247 .3 40% ‐1 81. 225 % 11 8 358 20 20 10 0% 26. 588 % 22. 50 6% 70 .913% 0. 31 7 0. 84 6 244 .1 72% ‐1 73. 259 % 11 8 358 Inde ks  P rod uk tiv ita s &  Ki ne rja Bi ay a  Ku m ul at if Pr oy ek si  P eng el ua ra n  Bi ay a  &  Wa kt u  Pe ny el es ai an  Pr oy ek Tabel 4.8 Pro yek si P en g eluaran Bia ya dan Jan g ka w aktu

(14)

4.3 FAKTOR-FAKTOR YANG BERPENGARUH TERHADAP BIAYA & WAKTU PELAKSANAAN PEKERJAAN BERDASARKAN HASIL ANALISIS

Hasil analisis dari variabel-variabel yang ada menunjukkan bahwa proyek tersebut :

a. Tidak bisa selesai tepat pada waktunya (dengan sisa waktu yang ada) b. Dengan proyeksi EAS (estimate all schedule), proyek tersebut berpotensi

membutuhkan tambahan waktu 118 hari atau membutuhkan 358 hari kalender untuk menyelesaikan total proyek dari awal hingga akhir.

c. Dengan proyeksi EAC (estimate all cost), proyek tersebut diperkirakan berpotensi menghabiskan anggaran 173,259% dari kumulatif actual cost minggu ke-20 (Rp 11.844.758.680,00) yaitu Rp 20.522.121.007,26.

Mengingat hal tersebut akan berakibat fatal bagi seluruh stakeholder, terutama bagi kontraktor yang akan menanggung seluruh penambahan biaya serta membayar denda kepada owner karena keterlambatan penyelesaian pekerjaan, maka perlu dilakukan pengendalian waktu serta biaya.

Berikut ini diuraikan beberapa faktor yang mempengaruhi biaya serta waktu pelaksanaan proyek. Dimulai dari tabel 4.9 mengenai faktor-faktor yang berpengaruh pada pembengkakan biaya tiap minggu proyek, tabel 4.10 mengenai faktor-faktor yang berpengaruh pada sedikitnya jumlah pengeluaran tiap minggu proyek, tabel 4.11 mengenai faktor-faktor yang berpengaruh pada keterlambatan progress pekerjaan proyek, dan tabel 4.12 mengenai faktor-faktor yang berpengaruh pada percepatan progress pekerjaan proyek.

(15)

Tabel 4.9

Faktor yang berpengaruh pada pembengkakan biaya tiap minggu

No Minggu Faktor 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 Frek. 1. Tidak dibuatkan scheduling order material yang baik sejak awal

9 9 9 9 9 9 9 9 9 9 9 9 9 9 9 9 9 9 9 9 20

3. Penambahan tenaga kerja & jam lembur

9 9 9 9 9 9 9 9 9 9 9 11

Dari tabel di atas dapat diketahui bahwa yang menyebabkan nilai varian biaya (CV) negatif atau dengan kata lain BCWP kurang dari ACWP adalah tidak dibuatkannya schedule pengadaan material (64,52%) dan penambahan tenaga kerja & jam lembur pada saat dilakukan akselerasi pekerjaan (35,48%). Kedua faktor tersebut merupakan faktor internal dalam manajemen proyek tersebut.

Tabel 4.10

Faktor yang berpengaruh pada sedikitnya jumlah pengeluaran tiap minggu No Minggu Faktor 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 Frek. 1. Lunasnya seluruh tagihan proyek - 2. Pembayaran order material relatif sedikit 9 9 9 9 9 9 6

Dari tabel di atas dapat diketahui bahwa yang menyebabkan nilai varian biaya (CV) positif atau dengan kata lain ACWP kurang dari BCWP adalah pada minggu-minggu tersebut pengeluaran biaya untuk proyek relatif sedikit (100%). Faktor ini berkaitan erat dengan schedule pengadaan material yang sebelumnya ada di tabel 4.9 yang menyebabkan nilai CV menjadi negatif, pada minggu-minggu tertentu setelah material diorder dan pembayaran uang muka,

(16)

ada jeda bagi keuangan proyek untuk bernafas hingga manunggu material yang dipesan tiba di lokasi dan diadakan pembayaran pelunasan.

Tabel 4.11

Faktor yang berpengaruh pada keterlambatan progress pekerjaan

No Minggu Faktor 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 Frek. 1. Curah hujan (cuaca) 9 9 9 9 9 9 9 9 9 9 9 9 9 9 14 2. Kendala dalam perijinan dan administratif 9 9 9 9 9 9 9 9 8 3. Adanya change order untuk pekerjaan selanjutnya yang berpengaruh pada perubahan desain 9 9 2 4. Keterlambatan karena

Alat belum tiba di lokasi 9 9 2 5. Keterlambatan karena material langka 9 9 2 6. Keterlambatan karena Listrik/air kerja mati 9 1 7. Keterlambatan pengiriman material 9 9 9 9 4 8. Kekurangan tenaga kerja & produktivitas

9 9 9 9 9 9 9 7

Dari tabel di atas, diketahui bahwa hal-hal yang menyebabkan keterlambatan pekerjaan (BCWP < BCWS) antara lain meliputi faktor internal (manajemen proyek) dan faktor eksternal. Faktor internal yaitu : kurangnya kemampuan berkoordinasi dengan pihak luar yang menyebabkan permasalahan perijinan &

(17)

administratif (20,00%) dan menyebabkan keterlambatan pengiriman material (10,00%) serta faktor internal yang tidak kalah pentingnya adalah mengenai produktivitas tenaga kerja (17,50%). Faktor eksternal yaitu : cuaca yang buruk/curah hujan tinggi (35,00%), change order (5,00%), keterlambatan alat oleh subkon (5,00%), kelangkaan material (5,00%), masalah listrik PLN dan air kerja yang sewaktu-waktu mati (2,50%).

Tabel 4.12

Faktor yang berpengaruh pada percepatan progress pekerjaan

No Minggu Faktor 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 Frek. 1. Perijinan lebih cepat dari jadwal 9 9 9 2 2. Akselerasi pekerjaan struktur (lintasan kritis) 9 9 9 3

Dari tabel di atas diketahui bahwa hal-hal yang berpengaruh pada percepatan proyek (BCWS < BCWP) adalah ketika pekerjaan perijinan yang memiliki bobot dan dinilai secara fidik telah terpenuhi (40,00%) dan dilakukan akselerasi perkerjaan struktur (60,00%)

(18)

4.4 HASIL PENELITIAN TERDAHULU MENGENAI FAKTOR-FAKTOR YANG BERPENGARUH TERHADAP BIAYA & WAKTU PELAKSANAAN PEKERJAAN

4.4.1 Faktor-faktor Yang Berpengaruh Terhadap Biaya Dan Waktu Pelaksanaan Pekerjaan :

A. Jurnal 1

Judul : Faktor – faktor resiko yang mempengaruhi kinerja waktu pelaksanaan konstruksi gedung secara swakelola Studi kasus : Proyek pengembangan sekolah menengah kejuruan di

provinsi Aceh

Ditulis oleh : Rusman, Muttaqin, Nurul Malahayati

Kata kunci : Faktor-faktor resiko, kinerja waktu, proyek swakelola Hasil : 7 (tujuh) faktor resiko utama yang berpengaruh terhadap

kinerja waktu pelaksanaan konstruksi gedung secara swakelola antara lain :

- Kemampuan dan kecakapan pelaksana (14.168%) - Singkatnya waktu pekerjaan (13.562%)

- Manajemen proyek yang kurang pengalaman (12.529%)

- Perpajakan (11.230%) - Gangguan cuaca (11.039%)

- Perkiraan BoQ yang kurang akurat (10.314%)

B. Jurnal 2

Judul : Akselerasi penyelesaian proyek dengan analisa

pertukaran waktu dan biaya (time cost trade off)

Studi kasus : Proyek pembangunan stadion olah raga Buruan di kecamatan Blahbatuh, Gianyar

Ditulis oleh : Dewa Ketut Sudarsana

(19)

Hasil : Percepatan (crash) tidak selalu berakibat pada peningkatan biaya total proyek, karena waktu yang ditetapkan dalam kontrak belum tentu waktu optimal.

C. Jurnal 3

Judul : Pengendalian waktu dan biaya pada tahap pelaksanaan proyek dengan menggunakan metode nilai hasil

Studi kasus : Proyek lanjutan pembangunan PIP2B Kota Manado Ditulis oleh : H. Tarore, G.Y. Malingkas, D.R.O. Walangitan Kata kunci : Motode Nilai Hasil, BCWS, BCWP, ACWP

Hasil : Konsep nilai hasil bisa diterapkan pada studi kasus ini di dalam tujuan pengendalian dimana berdasarkan analisis maka pengendalian yang dilakukan banyak terjadi penyimpangan dari sisi penjadwalan pada saat pelaporan-pelaporannya. Berdasarkan nilai ETC dan EAC yang terhitung, maka apabila kinerja tidak diperbaharui akan terjadi bergeseran.

D. Jurnal 4

Judul : Analisis faktor-faktor penyebab terjadinya

pembengkakan biaya (cost overrun) Studi kasus : Proyek konstruksi gedung di kota Ambon

Ditulis oleh : Tonny Sahusilawane, Mohammad Bisrei, Arif

Rachmansyah

Kata kunci : analisis faktor, kontraktor, pembengkakan biaya

Hasil : Faktor-faktor dominan penyebab terjadinya cost overrun adalah :

- Tingginya frekuensi perubahan pelaksanaan

- Terlalu banyak pengulangan pekerjaan karena mutu jelek

(20)

- Terlalu banyak proyek yang ditangani pada waktu yang sama

- Kurangnya koordinasi antara kontraktor dan subkontraktor

- Kurangnya koordinasi antara konsultan pengawas, perencana dan kontraktor

- Terjadi perbedaan/perselisihan pada proyek - Manajer proyek tidak kompeten/cakap

E. Jurnal 5

Judul : Analisa penyebab dan pengaruh change order

Studi kasus : Proyek infrastruktur dan bangunan gedung di Ambon Ditulis oleh : Willem Sapulette

Kata kunci : Change order, cause, impact

Hasil : Pengaruh change order pada proyek bangunan gedung yaitu pada jadwal pelaksanaannya, pada jumlah tenaga kerjanya dan pada peralatan proyeknya.

F. Jurnal 6

Judul : Analisis percepatan pelaksanaan pekerjaan dengan

menambah jam kerja optimum pada proyek konstruksi Studi kasus : Proyek pembangunan super villa, Peti Tenget - Bandung Ditulis oleh : Ariany Frederika

Kata kunci : percepatan, ms.project, lintasan kritis, cost slope, time cost trade off analysis, optimum

Hasil : Dari hasil analisis diperoleh :

- Biaya optimum pada penambahan 1 (satu) jam kerja dengan pengurangan biaya Rp 784.104,16 dan pengurangan waktu 8 hari

(21)

- Biaya optimum pada penambahan 2 (dua) jam kerja dengan pengurangan biaya Rp 700.377,35 dan pengurangan waktu 14 hari

- Sehingga, percepatan dengan biaya optimum didapat pada penambahan 1 jam kerja dan waktu optimum didapat pada penambahan 2 jam kerja

G. Jurnal 7

Judul : Pengaruh jam kerja lembur terhadap biaya percepatan proyek dengan time cost trade off analysis

Studi kasus : Proyek rehabilitasi ruang pertemuan dinas pertanian tanaman pangan provinsi Bali

Ditulis oleh : A.A. Gde Agung Yana

Kata kunci : Time cost trade off analysis, keterbatasan tenaga kerja

Hasil : Dengan keterbatasan SDM maka percepatan proyek

tersebut dilakukan dengan kerja lembur selama 4 jam sehari. Pengkompresian dilakukan pada item pekerjaan yang terdapat pada jalur kritis yang dimulai dari item pekerjaan yang memiliki cost slope terkecil. Kompresi yang dilakukan menyebabkan biaya langsung bertambah dan berkurangnya biaya tak langsung. Dari hasil perhitungan diperoleh :

- Waktu penyelesaian proyek optimum 117 hari dengan total biaya proyek Rp 1.018.549.188,40 - Waktu penyelesaian normal 150 hari dengan biaya

total proyek Rp 1.025.250.107,10

- Sehingga terjadi pengurangan durasi selama 33 hari dan penghematan biaya sebesar Rp 6.700.919,00 jika dilaksanakan kerja lembur 4 jam sehari selama masa lintasan kritis

(22)

4.4.2 Pengelompokan Faktor-Faktor yang Mempengaruhi Waktu dan Biaya Proyek

Tabel 4.13

Faktor-faktor yang berpengaruh terhadap waktu serta biaya pelaksanaan proyek dari hasil penelitian

No Faktor

Jurnal 1 Jurnal 2 Jurnal 3 Jurnal 4 Jurnal 5 Jurnal 6 Jurnal 7 Jurnal 8

Frekuensi

1 Faktor cuaca (curah

hujan)

9 9 2

2 Masalah perijinan & administratif

9 9 2

3 Sumber Daya Manusia

(SDM)

9 9 9 9 9 9 9 7

4 Delivery material 9 1

5 Change order jenis pekerjaan dan material

9 9 9 3

6 Pengulangan pekerjaan

karena mutu jelek

9 1

7 Ketersediaan alat 9 1

8 Ketersediaan material 9 1

9 Faktor masalah lokal

(listrik dan air kerja)

9 1

10 Jadwal order material 9 1

Keterangan :

Jurnal 1 : Judul “Faktor – faktor resiko yang mempengaruhi kinerja waktu pelaksanaan konstruksi gedung secara swakelola. Proyek pengembangan sekolah menengah kejuruan di provinsi Aceh.”

(23)

Jurnal 2 : Judul “Akselerasi penyelesaian proyek dengan analisa pertukaran waktu dan biaya (time cost trade off). Proyek pembangunan stadion olah raga Buruan di kecamatan Blahbatuh, Gianyar.”

Jurnal 3 : Judul “Pengendalian waktu dan biaya pada tahap pelaksanaan proyek dengan menggunakan metode nilai hasil. Proyek lanjutan pembangunan PIP2B Kota Manado.”

Jurnal 4 : Judul “Analisis faktor-faktor penyebab terjadinya pembengkakan biaya (cost overrun). Proyek konstruksi gedung di kota Ambon.” Jurnal 5: Judul “Analisa penyebab dan pengaruh change order. Proyek

infrastruktur dan bangunan gedung di Ambon.”

Jurnal 6 : Judul “Analisis percepatan pelaksanaan pekerjaan dengan menambah jam kerja optimum pada proyek konstruksi. Proyek pembangunan super villa, Peti Tenget – Bandung.”

Jurnal 7: Judul “Pengaruh jam kerja lembur terhadap biaya percepatan proyek dengan time cost trade off analysis. Proyek rehabilitasi ruang pertemuan dinas pertanian tanaman pangan provinsi Bali.” Jurnal 8: Judul “Kajian waktu dan biaya dengan earned value method pada

proyek Pembangunan Gedung TTC Manado II.”

4.4.3 Evaluasi Pengendalian dan Percepatan Proyek Secara Umum

Penjadwalan dan rencana yang baik mutlak diperlukan bagi suatu proyek konstruksi, karena selain melibatkan sumber daya yang cukup banyak juga karena sifat proyek yang unik (tidak ada proyek yang benar-benar sama). Jumlah dan kualitas personel, jumlah dan jenis data atau informasi, serta biaya harus dialokasikan sedemikian rupa sehingga perencanaan proyek selesai sesuai jadwal, sesuai anggaran dan menghasilkan rencana yang optimal. Namun pada pelaksanaan nyata di lapangan ada beberapa faktor yang sangat berpengaruh sehingga hasil akhir proyek menjadi tidak sesuai dengan teori yang kita pelajari.

(24)

Untuk melaksanakan percepatan pengerjaan proyek, ada beberapa alternatif tindakan yang dapat digunakan, yaitu:

- Penambahan jam kerja, - Penambahan tenaga kerja,

- Meminimalkan adanya change order, dan - Melakukan perubahan logika hubungan kerja.

4.5 TINDAK LANJUT MANAJEMEN PROYEK

Berdasarkan dari hasil kesimpulan, dipastikan bahwa proyek tersebut mengalami kemunduran waktu penyelesaian. Hubungan antar pekerjaan, volume dan spesifikasi pekerjaan, metode pelaksanaan serta aspek yang lain harus betul-betul kembali diperhatikan, terutama keterkaitan antar pekerjaan, sangat menentukan strategi yang tepat dalam menyelesaikan percepatan.

Dikarenakan banyaknya item pekerjaan yang harus dilakukan, hal ini berarti pula akan melibatkan cukup banyak vendor dan tenaga kerja. Akhirnya dituntut pengelolaan tenaga kerja yang memadai dalam rangka mencapai target waktu pelaksanaan serta kontrol terhadap cashflow yang lebih baik untuk menghindari pembengkakan biaya yang lebih besar.

4.5.1 Beberapa Hal yang Dapat Dilakukan untuk Percepatan Proyek Berikut beberapa hal dapat dilakukan untuk percepatan proyek :

A. Manajerial

1. Mengkomunikasikan jalur kritis dengan seluruh tim di proyek 2. Menjaga kedisiplian tim proyek

3. Melakukan rapat harian rutin hingga kondisi progress pekerjaan benar-benar stabil

4. Aktif menggali informasi mengenai potensi masalah 5. Melakukan update rutin atas jalur kritis

6. Memberi motivasi dan pekerja agar attitude serta mental dalam bekerjanya bisa lebih baik lagi

(25)

7. Menambah jam kerja dengan lembur 8. Menambah tenaga kerja

9. Menjaga kualitas pekerjaan, kualitas pekejaan yang tidak baik berpotensi akan menimbulkan pengulangan pekerjaan

10. Memastikan ketersediaan dana dan mengusahakan dana pendamping yang bersifat emergency

11. Membantu mempercepat proses penagihan termijn bagi subkontraktor

12. Aktif berkomunikasi dengan owner dan pengawas pekerjaan mengenai strategi percepatan

13. Memberikan reward atas tercapainya setiap tahapan milestone

14. Sistem K3 harus benar-benar diperhatikan, kecelakaan kerja menyebabkan lose time

B. Scope dan Lingkup Pekerjaan

1. Membuat checklist daftar sisa pekerjaan

2. Membuat daftar sisa pekerjaan dengan melihat keseluruhan dokumen kontrak (gambar, BoQ dan spesifikasi)

3. Meminimalisir adanya perubahan lingkup dan pekerjaan tambah-kurang

C. Critical Path Method

1. Membuat schedule sisa pekerjaan dimana target selesainya pekerjaan dibuat lebih maju untuk menghindari hal-hal yang tidak terduga 2. Membuat CPM berdasarkan update WBS

3. Memprioritaskan pekerjaan yang masuk dalam jalur kritis 4. Mengurangi sebanyak mungkin jumlah pekerjaan kritis

5. Menyebarkan satu rangkaian pekerjaan kritis menjadi beberapa jalur pekerjaan kritis (yang semula seri menjadi paralel)

(26)

D. Material dan Suplier

1. Pengiriman material menggunakan transportasi udara, mengungat ekspedisi jalur laut sangan dipengaruhi cuaca

2. Aktif memonitor proses pengiriman dengan meminta bukti manifest pengiriman material

3. Melakukan pengecekan terhadap ketersediaan material yang di pesan, apakah ready atau indent

4. Memastikan setelah proses approval diterima, sesegera mungkin memesan material tersebut terutama yang import & dengan spesifikasi khusus

5. Jika tiba-tiba terjadi kelangkaan material merk yang telah disepakati maka sesegera mungkin segera dibuatkan berita acaranya dan menggantinya dengan merk lain yang kualitasnya setara

E. Alat

1. Memastikan alat dirawat sesuai prosedur

2. Jika terjadi kerusakan atau ketidakcocokan, sesegera mungkin diganti

F. Subkontraktor

1. Mengurangi lingkup pekerjaan subkontraktor yang bermasalah dengan menggantinya dengan yang terbih terpercaya

2. Mengambil alih pekerjaan subkontraktor yang berpotensi terlambat 3. Aktif berkomunikasi dengan subkontraktor dalam hal masalah teknis

dan administratif

G. Tenaga Kerja

1. Mengganti tenaga kerja yang kurang produktif dengan yang lebih produktif

(27)

3. Aktif memantau kedisiplinan tenaga kerja

4. Memperhatikan kelayakan tempat tinggal pekerja

5. Aktif berkomunikasi dengan pekerja mengenai kesulitan pelaksanaan dalam event meeting

6. Memberikan training rutin 7. Mengkoordinir jam istirahat

8. Tenaga kerja harus disebar, tidak mengelompok

H. Desain dan Metode Pelaksanaan

1. Aktif menemukan metode pelaksanaan baru yang lebih efektif dan efisien

2. Aktif mengevaluasi metode pelaksanaan yang ada 3. Melakukan review desain

I. Kontrak

1. Melakukan negosiasi ulang kontrak apabila penyebab keterlambatan adalah karena kontrak

2. Mencatat secara harian dan mendokumentasikan hal-hal yang menjadi penyebab keterlambatan serta menyampaikannya dengan surat kepada owner

3. Pekerjaan tambah kurang yang menyebabkan keterlambatan harus didasarkan pada upaya percepatan, diusahakan pekerjaan tambah kurang kersebut tidak berada di jalur kritis

J. Site

1. Mengupayakan lokasi site selalu dalam keadaan bersih dan rapi 2. Memastikan akses akses masuk proyek tidak terhambat

(28)

4.5.2 Beberapa Hal yang Dapat Dilakukan untuk Pengendalian Biaya Berikut beberapa hal yang dapat dilakukan untuk pengendalian biaya :

a. Melakukan checklist material apa saja yang dibutuhkan untuk proyek & belum dipesan,

b. Menghitung jumlah kebutuhan upah tenaga kerja berdasarkan metode percepatan jika terjadi jam lembur/penambahan tenaga kerja,

c. Komparasikan antara pengiriman material jalur laut dan jalur udara, d. Memprioritaskan material yang berpengaruh terhadap jalur kritis agar

dipesan terlebih dahulu, agar lebih cepat sampai di lokasi proyek,

e. Merencanakan anggaran pelaksanaan dengan lebih matang lagi, mengingat banyaknya material impor dengan jumlah biaya yang besar, f. Memastikan ketersediaan dana dan mengusahakan dana pendamping

yang bersifat emergency,

g. Komparasikan antara biaya yang dikeluarkan untuk tambahan membayar upah tenaga kerja dengan biaya denda (dalam kontrak) jika terjadi penambahan waktu pelaksaan proyek atau progress -10,000% sesuai kontrak.

Gambar

Tabel 4.8  Proyeksi Pengeluaran Biaya dan Jangka waktu

Referensi

Dokumen terkait
